The manufacturing and logistics landscape across Maharashtra is shifting rapidly. Driven by the expansion of the Chakan-Talegaon industrial belt, Ranjangaon MIDC, and the sprawling logistical networks around Bhiwandi and Navi Mumbai, global enterprises are demanding highly specialized spaces. When standard leasable spaces fall short of fulfilling intricate functional specifications, businesses opt for a custom approach. A built-to-suit industrial facility in Pune offers corporations a bespoke, strategically designed environment optimized for their exact workflow.

However, moving away from a standard lease template introduces two major operational variables: financial capital expenditure and delivery timelines. How much does a built-to-suit warehouse construction or advanced manufacturing plant truly cost? How long does it take from breaking ground to initiating regular shifts?

This comprehensive guide breaks down the underlying costs, phase-by-phase timelines, and regulatory frameworks governing custom industrial facility construction in Maharashtra, helping you transition smoothly from planning to operational success.

Understanding the Built-to-Suit (BTS) Framework

Before looking at the metrics, it is vital to clarify what a Built-to-Suit (BTS) development entails. Unlike a speculative building—where a developer constructs a generic warehouse shell hoping a tenant will fit in—a built-to-suit industrial facility in Pune is conceptualized around the tenant’s blueprint from day one.

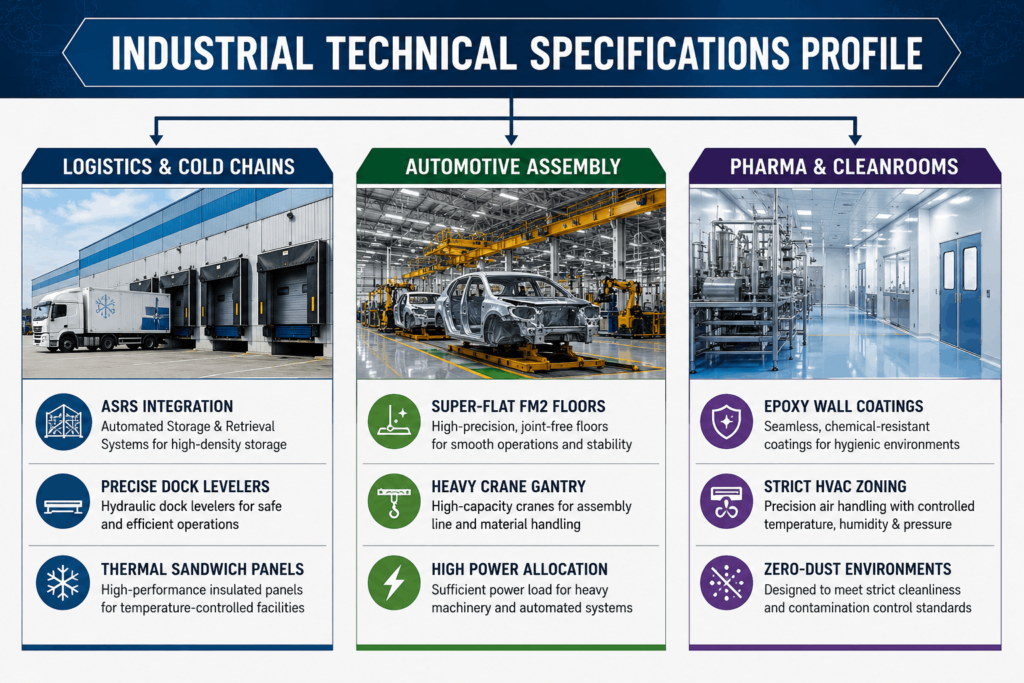

Every design choice is engineered to meet specific operational requirements, including:

Through this model, corporations bypass the inefficiencies and structural limitations of retrofitting existing setups, turning their facility into a core competitive asset.

BTS Industrial Building Cost Breakdowns

Evaluating a BTS industrial building cost requires separating core components. In Maharashtra’s primary industrial zones, total development costs generally fall into distinct brackets depending on whether you choose a Pre-Engineered Building (PEB) or a traditional Reinforced Cement Concrete (RCC) structure.

1. Structure Type and Materials

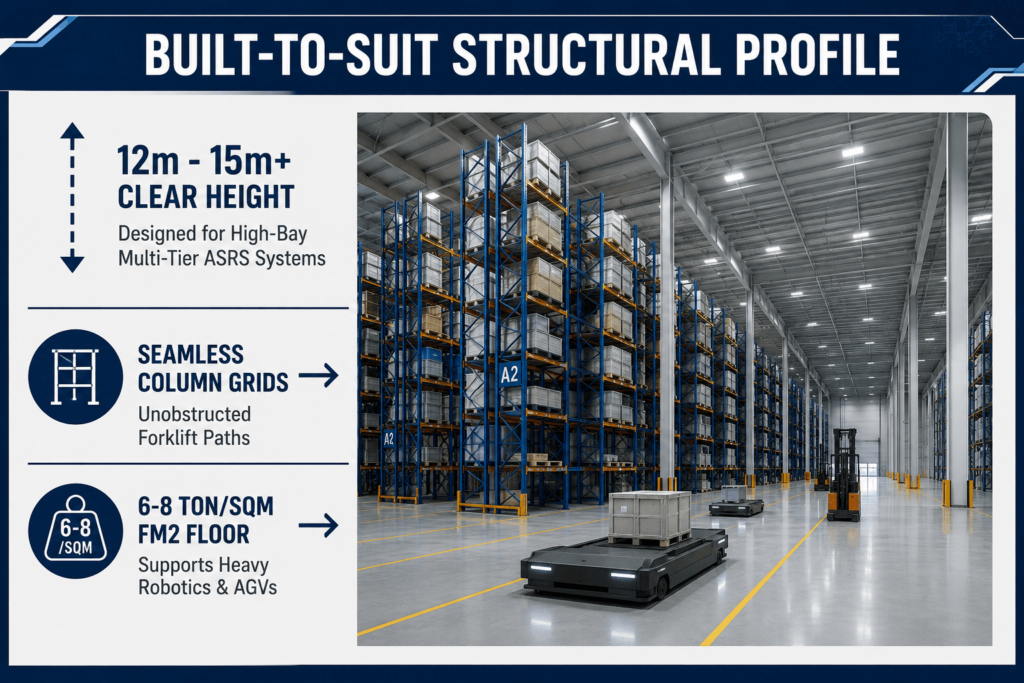

The structural engineering framework remains the largest variable within your custom warehouse construction cost per sq ft.

2. Flooring and Civil Work Specifications

Industrial floors are subject to constant dynamic loading and abrasion. Standard concrete mixes are insufficient for high-performance zones.

3. Mechanical, Electrical, Plumbing, and Fire (MEPF) Infrastructure

An automated facility requires a strong utility skeleton. Advanced fire protection and electrical grids represent a significant portion of the total investment:

Facility TypeMEPF Fit-Out InclusionsEstimated Cost Range (Per Sq Ft)
Standard WarehousingBasic internal illumination, standard ventilation, downcomer fire systems.₹150 – ₹300
Advanced Logistics / E-commerce HubHigh-lux LED layouts, ESFR (Early Suppression Fast Response) ceiling sprinklers, automated dock levelers.₹350 – ₹600
Precision Manufacturing / PharmaIntegrated HVAC climate zones, dust filtration, multi-megawatt power substations, process piping.₹700 – ₹1,500+

Hidden Factors Driving Industrial Construction Costs in Pune

When formulating an industrial capital expenditure budget, localized variables often catch project planners off guard.

1. Micro-Location Variations

While land costs are separate from structural expenses, local soil conditions across Pune’s industrial zones dramatically impact foundation designs. For instance, the black cotton soil prevalent in parts of Chakan and Ranjangaon demands deep pile foundations or extensive soil stabilization techniques. This can add ₹150 to ₹400 per square foot to early-stage civil budgets compared to firmer sites in the Talegaon area.

2. Steel and Material Market Trends

Because PEBs rely heavily on primary steel structural members, sudden global or national price shifts for structural steel impacts the bottom line. A typical industrial shed consumes about 8 to 12 kg of steel per square foot. Tracking these material variables is essential to prevent sudden mid-project budget overruns.

Detailed Industrial Construction Timeline and Phasing

Time is a critical financial factor when executing a built-to-suit factory construction Pune. A typical 100,000-square-foot facility takes anywhere from 8 to 14 months from initial conceptual designs to final handover, depending on structural complexity and local regulatory approvals.

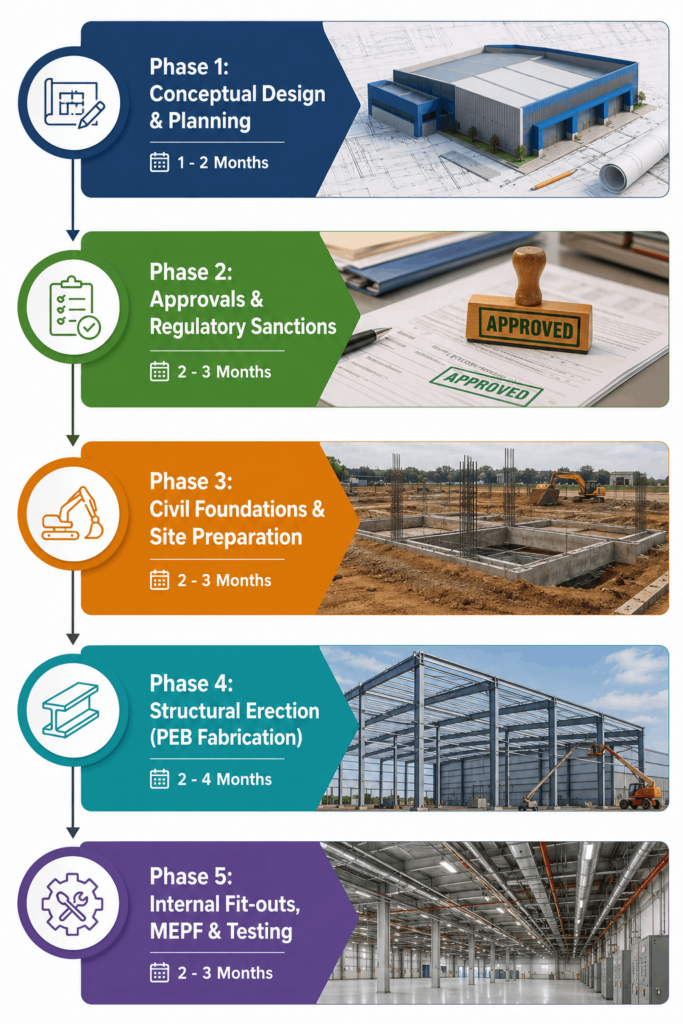

Phase 1: Conceptual Design and Engineering (1 to 2 Months)

During this initial window, structural engineers, architects, and the tenant’s operations team finalize layouts. Key outputs include soil testing, structural design modeling, and a detailed Bill of Quantities (BOQ).

Phase 2: Regulatory Approvals and Sanctions (2 to 3 Months)

This phase runs parallel to early supply chain planning. Securing permissions from regional bodies like the Maharashtra Industrial Development Corporation (MIDC), local municipal councils (PMC/PCMC), the Maharashtra Pollution Control Board (MPCB), and regional fire departments is essential to ensure legal compliance.

Phase 3: Civil Foundations and Site Engineering (2 to 3 Months)

Once approvals are granted, excavation begins. This includes mass grading, establishing underground utilities, drainage channels, and casting the main concrete footings or pile caps designed to anchor the main structural frames.

Phase 4: Structural Fabrication and Erection (2 to 4 Months)

For a PEB build, primary frame members are precision-manufactured off-site in a controlled factory environment. Once delivered, these steel components are bolted together on-site. This structural phase finishes with the installation of standard color-coated Galvalume or insulated PUF panels for the roof and walls.

Phase 5: Internal Fit-Outs, MEPF, and Commissioning (2 to 3 Months)

The final stage focuses on precision engineering: pouring super-flat concrete slabs, installing electrical substations, setting up fire suppression networks, and mounting heavy machinery or material handling systems. After comprehensive safety and performance testing, the facility receives its final occupancy clearances.

Streamlining Project Execution with Turnkey Solutions

Managing multiple independent contractors, architects, fabricators, and local compliance liaisons frequently leads to miscommunication, budget inflation, and project delays. Misaligned schedules can stall handovers and push back production timelines.

To mitigate these risks, forward-thinking organizations utilize turnkey industrial construction Pune models. Partnering with a single master contractor to handle everything from initial soil testing to final handovers offers several advantages:

Accelerating Production with Premium Industrial Engineering

Building a production-ready facility requires deep technical expertise, absolute structural integrity, and local regulatory knowledge. At Mcon India, we deliver end-to-end industrial engineering services tailored to your specific operational needs.

Whether you need a high-throughput distribution center featuring precise laser-screed flooring or an advanced automotive parts manufacturing plant with complex utility systems, our engineering teams ensure your project is completed on time and within budget. We handle the entire development cycle—including site evaluation, customized structural steel fabrication, and complex MEPF integrations—allowing your team to focus entirely on core business operations.

Ready to design your custom facility?

Contact our industrial construction experts today to receive an accurate, project-specific cost estimate and a clear timeline tailored to your upcoming build.

Get in Touch with Mcon India Contractors

Frequently Asked Questions

What is the average custom warehouse construction cost per sq ft in Maharashtra?

For a standard Pre-Engineered Building (PEB) warehouse with basic internal layouts, core construction expenses generally range from ₹1,200 to ₹1,800 per square foot. However, adding high-load floor configurations, custom insulated wall panels, or specialized fire safety infrastructure can increase costs between ₹2,000 and ₹2,800 per square foot depending on your technical requirements.

How does traditional RCC construction compare to PEB for industrial structures?

Pre-Engineered Buildings (PEBs) utilize high-strength steel components fabricated off-site, which can reduce total construction times by 30% to 40% compared to traditional reinforced concrete. Additionally, PEB frameworks allow for wide, column-free internal spaces up to 60 meters or more. Traditional RCC is typically reserved for complex, multi-story manufacturing layouts that support massive overhead machinery configurations on higher floors.

What key regulatory approvals are required for building a factory in Pune?

Before breaking ground, projects must secure a collection of clearances, including building plan approvals and commencement certificates from local development authorities like MIDC, PMC, or PCMC. Furthermore, developers must obtain industrial fire safety NOCs from the regional fire department, environmental clearances via the Maharashtra Pollution Control Board (MPCB), and formal utility layout permissions to connect to local power grids and municipal water supplies.

How does soil quality alter overall construction budgets in Chakan or Ranjangaon?

The expansive black cotton soils common across major industrial sectors in Pune can swell or shrink significantly depending on moisture levels. Constructing heavy-duty industrial structures on these sites requires deep pile foundations, specialized structural grade beams, or extensive soil replacement work. Accounting for these steps early on can add ₹150 to ₹400 per square foot to initial foundation and civil budgets.
